What a Drying File Contains: Water Damage Project Documentation

BYSteve Jafari, General ManagerNORTHERN VIRGINIA, MARYLAND & D.C.

A drying file is a chronological evidence chain: pre-work photographs, a moisture map, daily readings with psychrometric conditions, an equipment log that matches the invoice, and a documented drying goal that closes the job. This guide lists what belongs in each part, why each part is recorded, and the omissions that most often leave a file incomplete.
Call 1-888-29-FLOODWhat is a drying file, and who actually reads it?
A drying file is the documentation package for a water mitigation job. It holds pre-work photographs, a moisture map, daily readings with the psychrometric conditions around them, an equipment log, a materials record and a drying goal that the final readings meet. It answers four questions for anyone who reads it: what was wet, how wet it was, what was done about it, and when the structure reached a dry standard.
The file may be read by the property owner, by the owner's insurer if the owner shares it, or by another professional. None of them were in the house on day one, so anything that was not recorded effectively did not happen.
The habit comes from the ANSI/IICRC S500 water damage restoration standard, which treats inspection, monitoring and documentation as part of the work itself. It is industry practice, not a statute. We build the file the same way on every job, including the small ones.
- 1. Pre-work photographs of the source, the affected rooms and the contents
- 2. A moisture map showing wet areas and where each reading was taken
- 3. Initial readings with a dry standard from an unaffected area
- 4. Daily readings with matching psychrometric conditions
- 5. An equipment log with placement, quantity and removal dates
- 6. A materials record: what came out, how much, and why
- 7. Final readings and a signed completion that closes the drying goal
What has to be photographed before anything is touched?

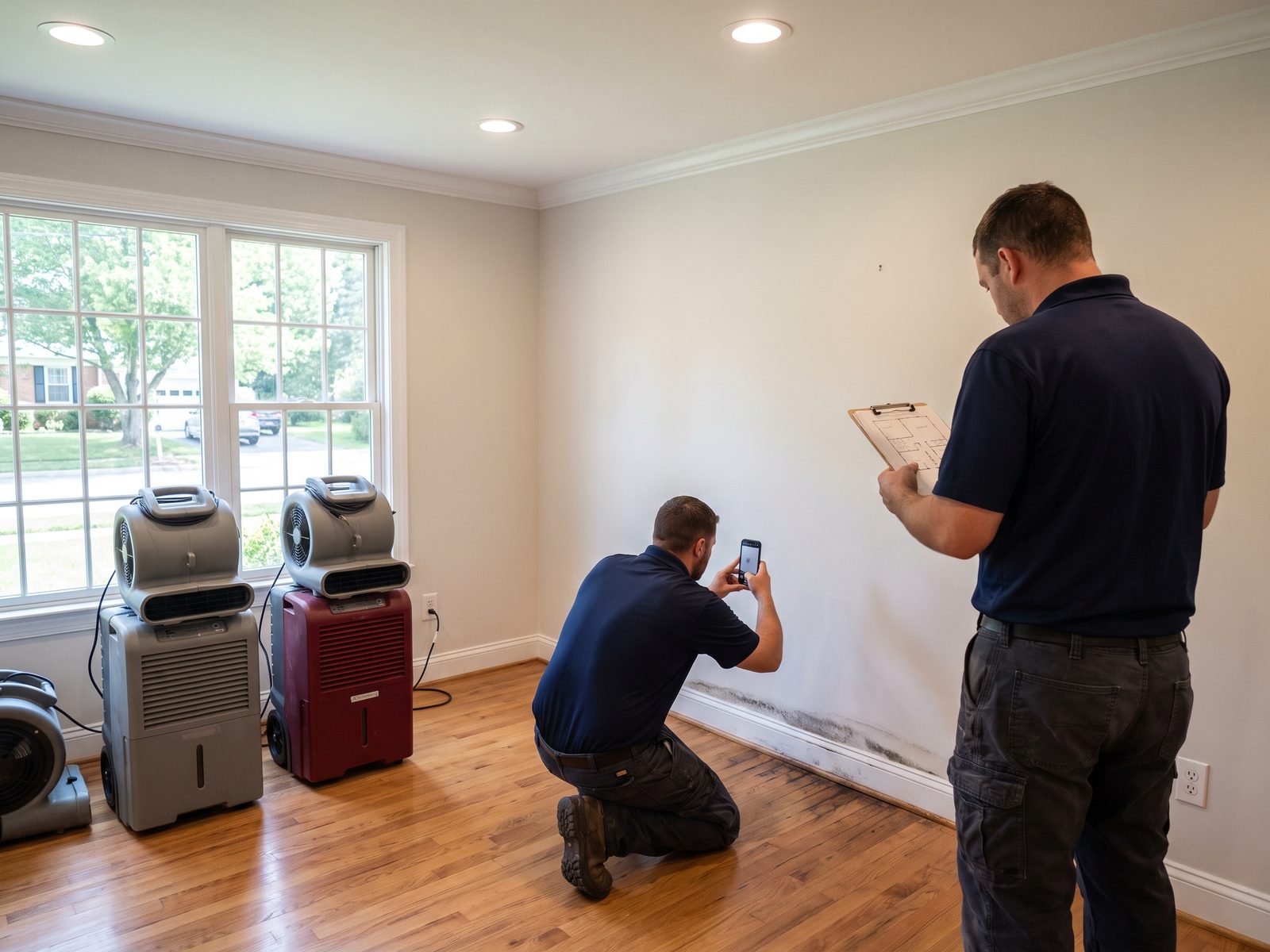

Photograph the source of the loss, every affected room from wide to tight, the water line on walls and cabinets, the contents at risk, and any damage that existed before the water arrived. Those frames are taken before extraction starts. Once the water is gone, the strongest evidence of the loss goes with it.
The sequence that survives review is wide, medium, tight. A wide frame from the doorway establishes the room. A medium frame puts the wet zone in context, so a reader can see the stain sits below the failed supply line. A tight frame shows the split hose or the wicking on the baseboard. A close-up that cannot be placed in a room is of little use.
Pre-existing damage deserves its own frames. If the hardwood already cupped from an older leak, photograph it and note it. That keeps older damage separate from new damage in the record.
- The source, close enough to show the failure and wide enough to place it
- Each affected room from the doorway, then the wet zone, then the detail
- Water lines on drywall, baseboard, cabinet bases and door casings
- Contents in contact with water, including what was moved and where
- Pre-existing damage, stains, cupping or prior repairs
- The moisture meter in frame against the material it is reading
What is a moisture map, and why is one included?

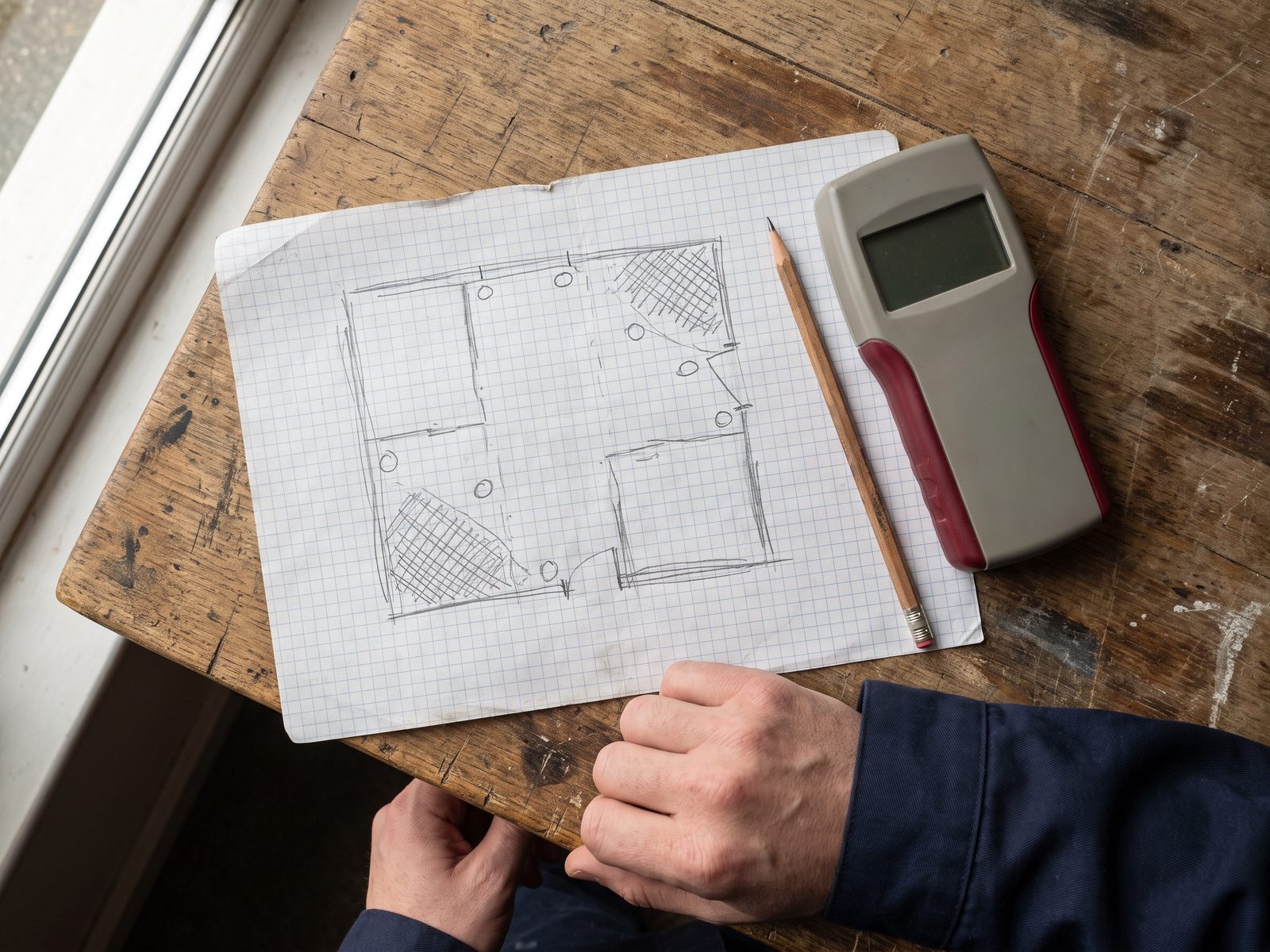

A moisture map is a floor plan of the affected area with the wet zones marked and each reading point numbered, so every number in the log has a place on a drawing. It turns a column of readings into something a reader can picture in seconds.
It does not have to be pretty. A hand sketch on graph paper works, as long as rooms are labeled, dimensions are close and the wet perimeter is drawn where moisture actually stopped. Water does not respect walls. A supply-line break in a McLean powder room routinely wets the hallway subfloor and the far side of a shared wall.
The map also disciplines the estimate. If the drawing says the wet area runs eleven feet into the hallway, the estimate should carry about that much affected flooring. Label points so they never change: point 1 is the same stud bay on day four as it was on day one.

What do daily readings have to include to be usable?

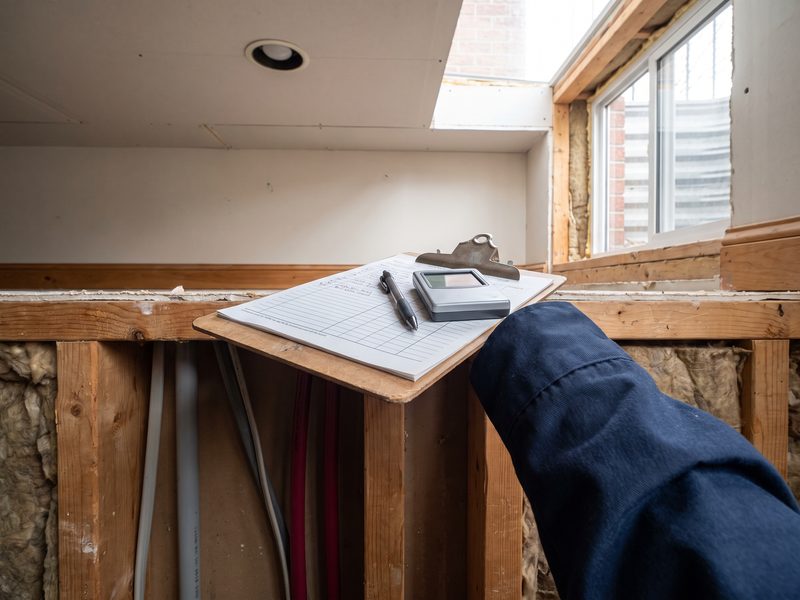

A usable reading records the date and time, a location ID that matches the moisture map, the material, the meter type, the value, and the dry standard it is compared against. Miss one of those and the number is data without meaning.
The dry standard is the reference value for the job. Drying is not finished at a fixed number on a meter. It is finished when affected material reads at or near the same value as the same material in an unaffected part of the building. That comparison is taken on day one, before equipment goes in.
Take readings at the same time of day with the same instruments. A pinless meter reads a relative scale through the surface. A penetrating meter reads moisture content at depth. Mixing the two across days produces a chart that looks like the material got wetter overnight, and that is hard to explain later.
| Field recorded | Why it is recorded | Common failure |
|---|---|---|
| Date and time | Establishes the drying curve and monitoring interval | Several days logged at once from memory |
| Location ID | Ties the number to a point on the moisture map | Vague labels that change day to day |
| Material | Drywall, framing and subfloor dry at different rates | One reading used for a whole room |
| Meter type | Pinless and penetrating scales are not interchangeable | Instruments swapped mid-job with no note |
| Value | Shows measurable progress toward the goal | Flat numbers with no note on the plateau |
| Dry standard | Defines when drying is actually complete | No unaffected comparison reading taken |
Why do psychrometric numbers matter, not just the moisture readings?
Psychrometric readings are the temperature and humidity measurements that show the drying environment could actually remove water. Moisture content readings prove the material got drier. Psychrometrics prove the equipment caused it. Together they show both that the material dried and why.

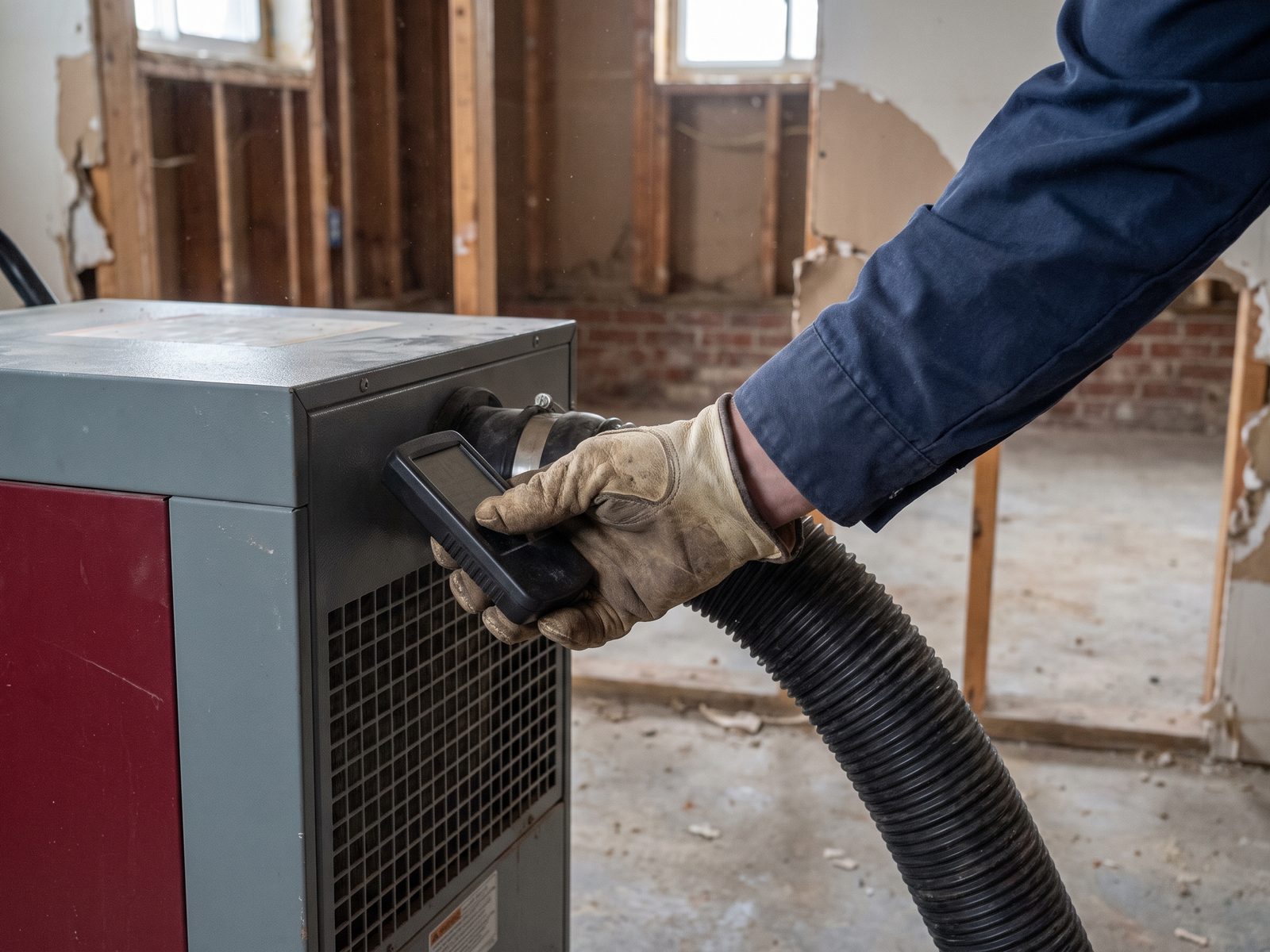

The set taken on a normal job is small. Temperature and relative humidity in the affected area. The same pair in an unaffected area, which acts as the control. The same pair outside. Then the air entering the dehumidifier and the air leaving it. From those, a technician derives grains per pound, the number that says how much water the air is holding.
Those readings answer questions that are hard to answer afterward. Why did drying take six days instead of three? Because outside air sat near saturation all week. Why is there a second dehumidifier on the invoice? Because the inlet and outlet readings show the first was at capacity. Neither answer can be reconstructed afterward.
There is a second reason to keep the environment on record. Warm, wet air is how a contained water loss becomes a mold problem, and EPA guidance puts fixing the water problem and drying materials completely at the front of any mold cleanup.

How is the equipment log tied to the invoice?
Every equipment line on the invoice should trace to a log entry: what the unit was, where it sat, the day it was placed and the day it was pulled. Equipment is billed in unit-days, so the log is the arithmetic behind the largest recurring charge on most mitigation estimates.

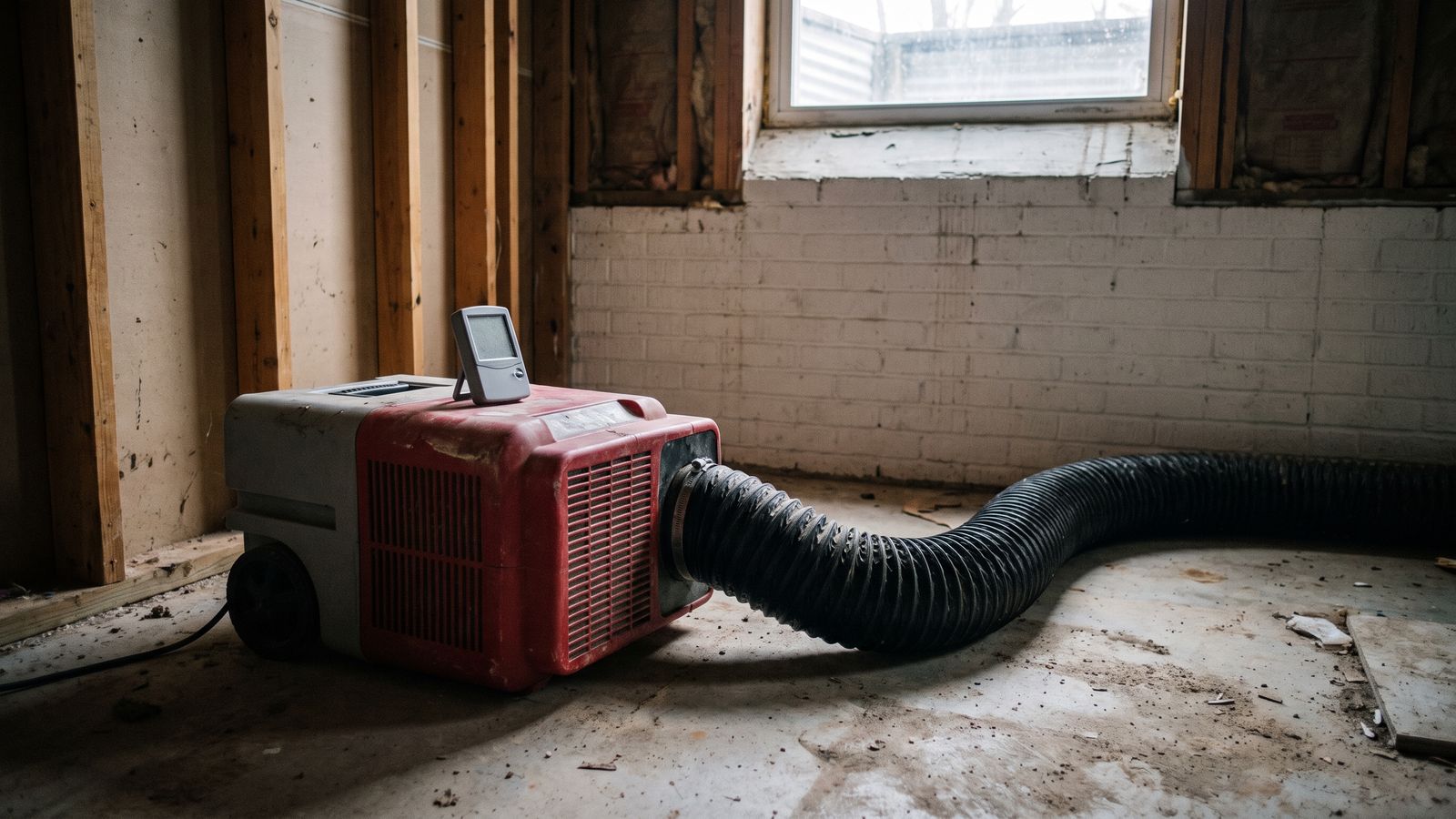

Air movers are counted, not described. Dehumidifiers are recorded by class and capacity, because a low grain refrigerant unit and a desiccant unit carry different rates. Air scrubbers need a reason tied to the water category or to a containment. Placement photographs taken the day equipment goes in are worth more than any note, because they show the count in the room.
Three mismatches are the most common problems in equipment logs. Equipment appears on the invoice with no placement date. The log ends before the final readings do, which leaves it unclear whether equipment ran after the structure was dry. Or the count in the log does not match the count visible in the photographs.

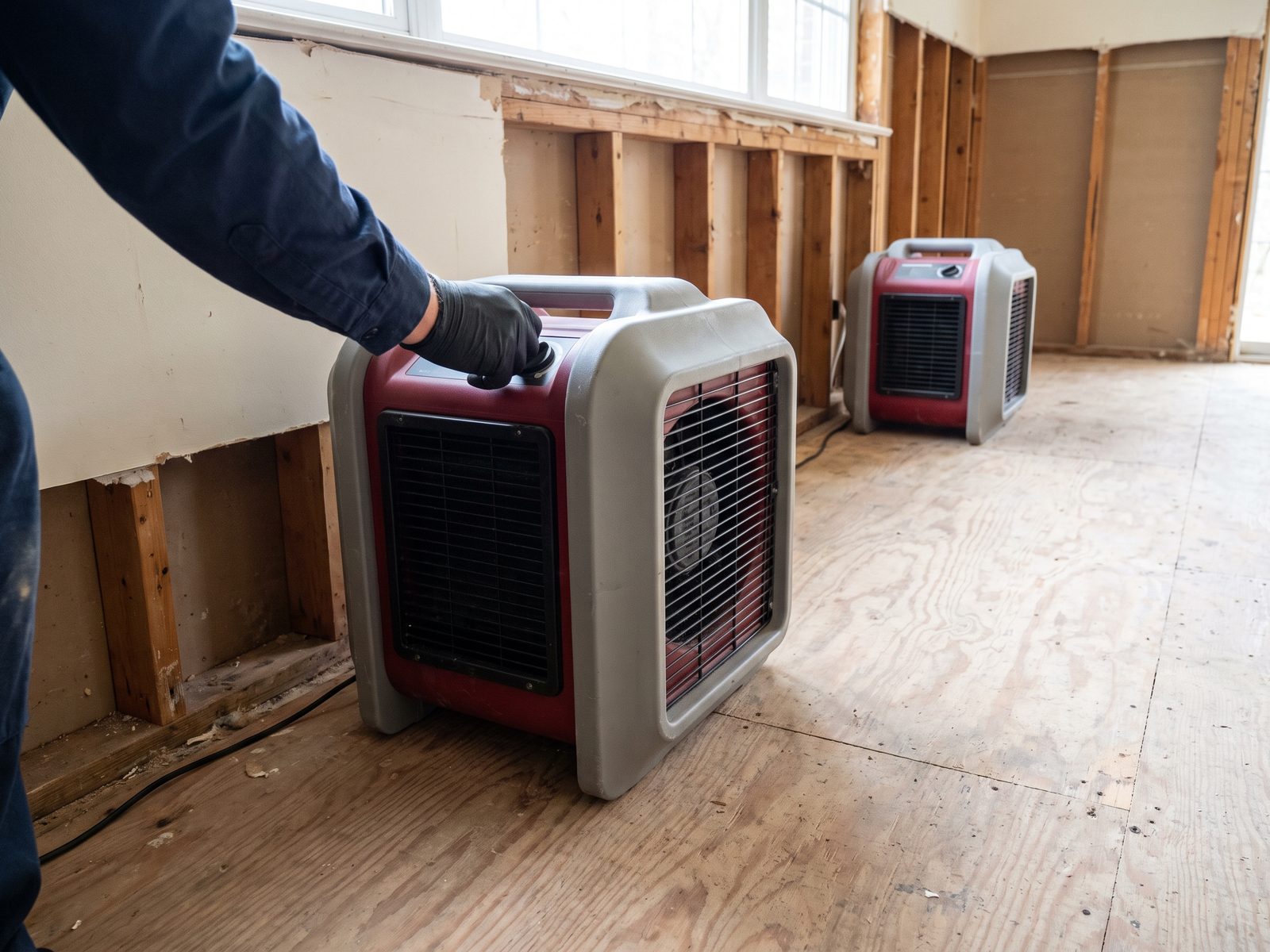

- Air movers: quantity per room, placement date, removal date
- Dehumidifiers: class and capacity, inlet and outlet readings, dates
- Air scrubbers: the reason for use, filter stage, dates
- Supplemental heat or injection drying: what it served, for how long
- Placement photographs from the day equipment is staged in each room
- A relocation note for any unit moved between rooms mid-job

What justifies removing a material, and how is that recorded?
A material comes out when it cannot be dried in place, when the category of water contaminated it, or when it hides a wet cavity that surface airflow will never reach. The file records the reason before the demolition, with the measured quantity and photographs taken before, during and after.
Category drives most of these calls. Clean water from a supply line leaves far more material salvageable than water from a sewer line. Porosity drives the rest. Carpet pad and insulation hold water and rarely justify the drying time. Framing and sealed concrete usually dry in place. Drywall depends on how high the water wicked and what sits behind it.
Quantities have to be measured in the units the estimate uses: linear feet of baseboard, square feet of drywall at a stated cut height, square feet of flooring and pad. A flood cut shown at two feet and billed at four is a contradiction in the record.
The strongest removal documentation shows the open cavity. A photograph of saturated insulation or a wet sill plate justifies the cut better than any written note.
What is the drying goal, and what closes the file?
The drying goal is the target value each affected material has to reach, taken from the same material in an unaffected part of the building on day one. The file closes when final readings meet that goal, final photographs are taken, equipment is logged out and the property owner signs a completion.
Skipping the goal is the quiet way a good job produces a bad file. With no stated target, the length of the drying is a matter of opinion. With a target on record, the last page shows: here is the start, here is the standard, here is the day it was met.
Final photographs mirror the first set. Same rooms, same angles, equipment gone, materials dry. That pairing shows the before and after condition in seconds.
A completion signature matters more than homeowners expect. It records the date the owner agreed drying finished, which separates mitigation from the repair work that follows.
Which four omissions most often leave a drying file incomplete?
Four gaps account for most incomplete drying files, and all four are cheap to prevent on day one. No pre-work photographs of the source. Readings with no location identity. An equipment log that does not line up with the invoice. And no dry standard, which leaves the drying goal unproven.
The first is the most expensive. If the only photographs came after extraction, nobody outside the house can see the original extent, and the original extent is hard to show. The second is quieter. Readings labeled only by room cannot show that the same point got drier, so the log proves the crew visited and nothing more.
The third gap is arithmetic. A log missing placement or removal dates leaves the number of days run unclear. The fourth ends arguments before they start. Without a dry standard from unaffected material there is no agreed finish line, so the length of the drying becomes opinion rather than record.
- 1. No pre-work photographs, so the original extent cannot be seen
- 2. Readings with no fixed location ID, so no point can be shown drying
- 3. An equipment log missing placement or removal dates for billed units
- 4. No day-one dry standard, so the drying goal was never defined
What should you ask your contractor to send you at the end of the job?
Ask for the complete file in a format you can open and forward, and ask at the end of the job rather than weeks later. A one-page summary is not a drying file, and the parts are listed below.
Restoration Doctor invoices the property owner and provides the drying file to the owner, who may share it with their insurer.
Read the file once before you share it. Check that room names on the map match the estimate, that equipment dates cover the days being billed, and that the last page shows final readings against a stated goal.
Sources: the ANSI/IICRC S500 Standard for Professional Water Damage Restoration and EPA mold cleanup guidance
- The full photograph set, not a selection, with capture dates intact
- The moisture map, even if it is a hand sketch on graph paper
- Every monitoring reading, including the day-one dry standard
- The equipment log with placement and removal dates per unit
- The materials record with quantities and a reason for each removal
- Final readings and the signed completion that closes the job
